Skip to main content
Planview Customer Success Center

Creating Projects from a Template

This video demonstrates how to create a project. Duration: 6.5 min.





This topic describes how to:

In addition, this topic includes a discussion of how the Schedule From date impacts project scheduling.

Note that when you create a project from a template, project permissions (aside from the permission to create a project) are ignored during the create process. This allows the project creator to select any of the elements available for copying from the template, regardless of the permissions granted to the project creator/owner. Once the project is created, permissions will be enforced. For example, let's say your owner profile includes the minimum permissions of View/Edit project Details. The project creator can include any project elements - tasks, team members, allocations, for example - to copy to the new project. Once the project is created, the owner will not be able to view/edit tasks in those elements - only project Details - as determined by the Owner profile.

Creating a project from a template

When you create a new project and immediately populate it from a template project, you can automatically create project elements, such as staffing allocations, teams, tasks, and so on, as they are defined in the template project. The new project will also import the template project's Details data, such as Project Type, Status, and Owner.

If you are populating tasks from the template project, note that the Start and Target dates will be read only. If you do not populate tasks from the template project, then the Start and Target dates will be editable.

Schedule From Date and Task Dates

When you create and populate a project from a template project, the project's Schedule From date defaults to today's date, regardless of what the date is set to in the template project. The duration of all tasks and all allocations is preserved, but the dates are shifted according to the new Schedule From date. The change in Schedule From date essentially works like shifting task dates while maintaining task duration.

In addition, any tasks that have constraints will honor the date differences between the Schedule From date on the template and the new Schedule From date in the new project. For example, if a template has a Schedule From date of 1/1/2016 and a task has SNET constraint set to 1/1/2019, the difference between the Schedule From date and the task's SNET of 1/1/2019 is 3 years. When you create the new project from the template and enter a Schedule From date of 1/1/2020, the 3 year offset for that task gives a Start Date of 1/1/2023. Any allocations imported from the template will be re-contoured according to the offset between the template's Schedule From date and the new project's Schedule From date.

Note that for active tasks calendar events are considered, and could impact the Start and Target Date of the task (but duration will be preserved). For manually scheduled and inactive tasks, calendars are not considered (but the offset is).

Example: The following screenshots show a set of tasks/constraints that are copied from the template project into the new project that has a different Schedule From date. An example set of allocations is also included.

Project template with Schedule From date 1/1/2016:

image (9).png

New project created from template, Schedule From date 1/1/2020:

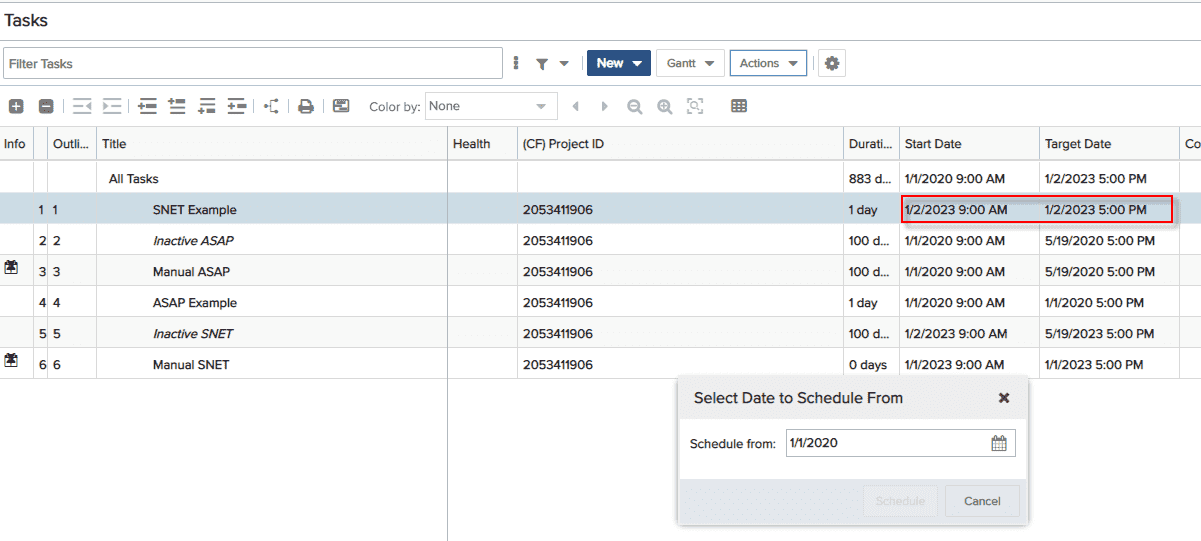

Note the 3 year offset and the resulting 1/1/2023 Start Date due to the 3 year offset from the SNET task date. Also, the first task's Start Date is 1/2/2023 because 1/1/2023 is a Sunday, which is not a working day for this project's calendar.

image (10).png

Example Allocations:

Template project with schedule From date of 1/1/2016

image (11).png

Template project with schedule From date of 1/1/2020

image (12).png



To create a project and populate it from a template project

  1. Click the Projects tab.

You can also create project from any Department Basic Info page if you have the appropriate rights to create projects for that department.

  1. Click the New button to invoke the New Project Wizard.


  1. In the new project wizard Step 1, select a category for the project. If your organization has one project category only defined, then you will not see this field on the wizard.

The Schedule From date defaults to the current date. Make adjustments as necessary.

  1. To populate the project's default values from a template project, select the template project. A list of project elements will appear. Note that this list will vary depending on the category you have chosen for the new project, and the category associated with the template project. For example, if the new project category does not include an Attachments tab, then Attachments will not be in the list.


  1. Select the specific elements to copy - you can select individually or copy all elements.
  • Team Members - Copies the project team members of the template project to the newly created project's team.

  • Staffing (resources & role allocations) - Copies the staffing assignments from the template project to the newly created project. Note that to import allocations (staffing), you must also import project team members. The newly created allocation will use the start/target dates from the target project.

    • If you are using centralized staffing, proposed staffing requests in the template project will be copied to the target project Staffing screen as an unstaffed role with a status of "New" (the request for the proposed resource will not be copied to the target project, just the role).

  • Tasks - Copies the task from the template project to the newly created project. If you choose to populate tasks, you can configure the system to email an alert to each task owner upon task creation. Enable Send alert to owner on populate tasks to notify task owners of task creation

  • Task Schedules (resource schedule) - Copies the task schedules from the template project to the newly created project. Note that to import task schedules, you must also import tasks, allocations (staffing) and team member. See discussion above about tasks dates relative to project Schedule From date.

  • Issues - Copies issues from the template project to the newly created project.

  • Attachments - Copies any attachments from the template project to the newly created project.

  • Dashboard Links - Copies any dashboard links from the template project to the newly created project.

  • Financial Entries - Forecasts - Copies any forecast entries (includes forecast amounts) in the template project to the new project (actuals are not copied). The "From Date" on any copied forecast entry is the project start date (not the template project start date); if available, copy the "To Date" from the forecast entry and adjust, if necessary, to keep relative to the "From Date".

  • Project Calendar - Copies the template project calendar to the newly created project.

  • Alert Routes - Copies the alert routes from the template project to the newly created project.

  1. Click Next.
  2. Fill in at least the required fields.
  3. Click Save.

If you chose to save a note documenting the imported elements, you can find it in the Notes section of the new project.


You are now ready to edit your new Project.

Populating an existing project from a template

Populating an existing project from a template automatically creates project elements based on the template elements, just like when creating a new project from a template.

You can populate an existing project from a template if the existing project does not contain any allocations or tasks. If these items exist in the target project, then the Actions > Populate from Template menu item will not be not be available in the project's Details section. Note that if both the target project and the template project have any of the same team members on both projects, new team members are copied, but we do not remove team members or update existing team members/profiles.

Schedule From date - all tasks are offset by the difference between the template's Schedule From date and the target project's Schedule From date.

Note that when you populate an existing project from a template, permissions are enforced on the copy. For example, if you do not have permission to edit tasks, but check "Populate Tasks" in the template, no tasks will be created/populated in the target project.

Note: Existing projects already contain a set of metadata, such as Project Type, Status, and Owner. When populating an existing project from a template, this information will not be copied from the template.

To populate an existing project from a template project

  1. Open the project and navigate to the Details section.
  2. Choose Actions > Populate from Template.
  3. Select the template project. You are presented with the list of template projects that are available for use.
  4. Select any or all of the following items to be populated/copied to the project: Project Team Members, Allocations, Tasks, Task Schedules, Attachments, and Project Calendars.
  5. Click Save.

Creating a project from a project type request and populating it from a template

Requests that are of item type "project" can be set to automatically create a project upon approval, or even prior to approval if permission has been granted to create the item early. If you are creating a project from a request, you can also choose to populate the project from a template project. If you have mapped fields in your request, the following happens:

  • If a mapped field exists in the template project, then the mapped request field is created in the new project

  • If a field exists in the template project but is not mapped in the request, the field from the template project is created in the new project

Schedule From date

When you create a project from a request and populate the project from template project, the project's Schedule From date defaults to "today's" date (the date you are creating the project from the template), regardless of what it is set to in the template project. The duration of all tasks is preserved, but the dates are shifted according to the new Schedule From date. The change in Schedule From date essentially works like shifting task dates while maintaining task duration.

Any allocations imported from the template will be re-contoured according to the new dates.
