Planning Series Automation

A Planning Series is the planning calendar used by your board, which is a sequence of Planning Increments you assign to cards to organize and plan work over time. Many organizations nest increments (for example, a PI with sprints inside it). Your series names and structure may differ, but the pattern is the same: cards can be assigned to one or more increments, and sometimes to increments from more than one Planning Series on the board.

planning increment.png

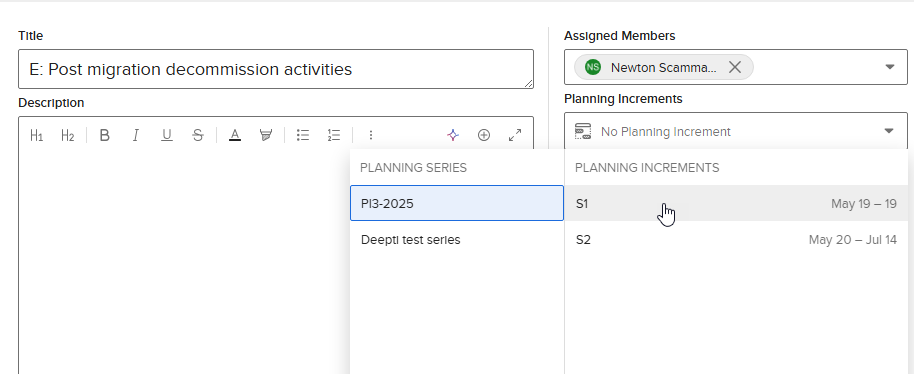

Assigning a card a Planning Increment

If increment assignments aren’t actively monitored, they can drift and throw off filters and reporting. Card Automation helps by applying your Planning Series calendar on a schedule or at card events so assignments stay current without a weekly manual chore.

Because planning increments can be nested, you are also asked to specify top-level or sub-level so date rules and actions apply to the increment you intend, not the wrong layer of the calendar.

Term

Meaning

Often referred as ...

Top-level

The increment at the top of the series hierarchy

The PI (program/quarter bucket)

Sub-level

A nested increment under a top-level increment

A sprint

Example: One quarterly PI (top-level) with two-week sprints (sub-level) underneath.

Why this matters

  • Date rules (start/end “days ago” or “from now”) run against increments at the level you specify. Use Sub-level when the use case is about sprints; use Top-level when it is about the PI.

  • Move to next advances along the Planning Series order at the level you chose. On the last sprint under a PI, “next” can be the next PI or its first nested increment.

  • A card can have both a PI and a sprint assigned; pick the level that matches what you are automating (sprint rollover vs PI change).

Card Automation Basics

Every automation has three parts:

  1. When to run: What event starts the check (for example, a card moves, or a scheduled run).

  1. Criteria : Which cards qualify (lanes, status, Planning Increment rules, and more).

  1. Action: What happens next (change increment, move card, clear increment, and so on).

See below for example use cases, and what criteria and actions to apply.

Example Use Cases

#

Use Case

When it runs

What it does

1

Sprint rollover

Scheduled

Unfinished cards move to the next sprint when the current sprint ends

2

Sprint start pull

Scheduled

Backlog cards move into an active lane when the sprint starts

3

Clear increment when done

Card moved

Removes increment assignment when work hits Done

4

Assign new cards with current sprint

Card created

New cards get today’s sprint automatically

Use Case 1: Sprint rollover

Use when: Unfinished work should move to the next sprint when the current sprint’s end date has passed.

Step 1 — When to run

  • Event type: Scheduled Time

  • Recurrence: Weekly

  • Day/time: Choose a weekday that follows your usual sprint end cadence (for example, Monday after a Friday sprint end), or select every day to evaluate every day. Uses your local desktop’s time zone.

Step 2 — Criteria

  • Card lanes: Open/active only (exclude Finished)

  • Planning Increments: Has an increment assigned

  • Planning Increment Level (for date rules): Sub-level because you are rolling over to the next sprint, not the next increment.

  • Planning Increment end date: Is less than this number of days ago → 7 if running once weekly

Step 3 — Action

  • Action type: Set Planning Increment

  • Mode: Move to next planning increment

  • Level: Sub-level

  • Shift Mode:

  • Keep current planning increments and add the adjacent one, to maintain history of all targeted sprints on the card

  • Replace current planning increments, to represent the latest sprint the card is completed on

Tips

  • If the sprint that ended is the last sprint under a PI, cards will be added to the next planning series increment (for example the next PI or the first sprint under it).

  • For Daily schedule: select all Days of the Week + end date 0 days ago.



Use Case 2: Sprint start pull

Use when: You use a lane for active sprint work and want backlog cards pulled in when the sprint starts.

Step 1 — When to run

  • Event type: Scheduled Time

  • Recurrence: Weekly

  • Day/time: Choose a weekday that follows your usual sprint end cadence (for example, Monday after a Friday sprint end), or select every day to evaluate every day. Uses your local desktop’s time zone.

Step 2 — Criteria

  • Lanes: Your specified backlog lane

  • Planning Increments: Has an increment assigned

  • Planning Increment Level (for date rules): Sub-level because you are pulling cards into a new sprint, not the next increment.

  • Planning Increment start date: Is less than this number of days ago → 7 if running once weekly

Step 3 — Action

  • Action type: Move Card

  • Destination Board/Lane: Your active work lane (for example, “In Progress”)

Tips

  • For Daily schedule: select all Days of the Week + end date 0 days ago.



Use Case 3: Clear increment when done

Use when: Finished cards should not keep increment assignment on reports and views.

Step 1 — When to run

  • Event type: Card Moved to Lane

Step 2 — Criteria

  • Lanes: Lane that represents finished

  • Increment assignment: Has at least one planning increment

Step 3 — Action

  • Action type: Set Planning Increment

  • Mode: Clear planning increments

  • Level: Select "All levels" to completely remove all series from card.



Use Case 4: Assign new cards with current sprint

Use when: Every new card should be assigned to whichever sprint is active today.

Step 1 — When to run

  • Event type: Card Created

Step 2 — Criteria

  • Lanes: Target newly created cards in specific lanes

  • Planning Increment: No increment assigned

Step 3 — Action

  • Action type: Set Planning Increment

  • Mode: Set to current planning increment

  • Planning Series: Select the applicable current planning increments defined for the board

  • Level: Sub-level because you are assigning at the sprint level

  • Update Mode: Add selection to existing planning increments
